← Back to Blog
Blog / House
The House Remodel: 52 Days In
January 3, 2026
Move-in target
--
March 8, 2026

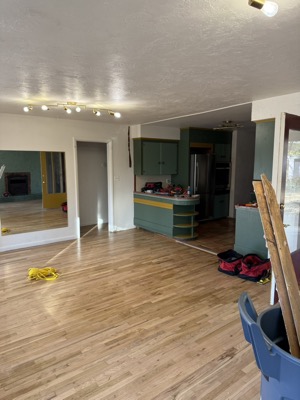

We closed on November 12th. Got the keys on the 13th. Work started the 14th. The house was built in 1956 and had seen some questionable renovations. Galvanized plumbing throughout. A damaged sewer line. Walls covered in horrible plaster. The backyard was a jungle.
Quick Facts
- Days In — 52
- Year Built — 1956
- Sewer Line — ~$400 (vs $13k quoted)

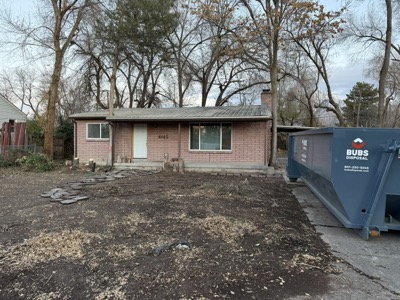

- Dumpsters — 4
- Home Depot Trips — Lost count
Timeline

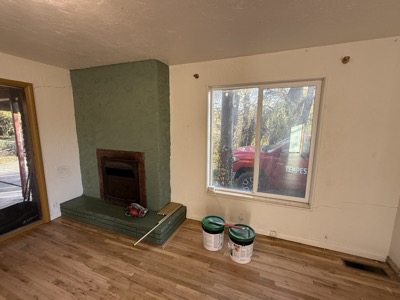

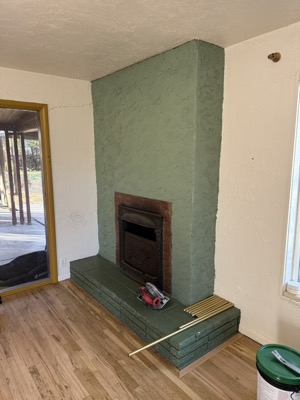

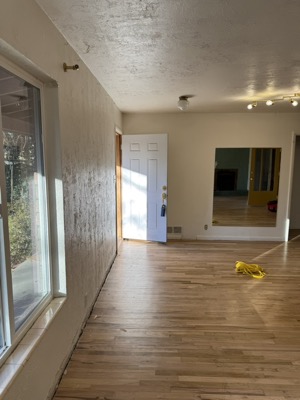

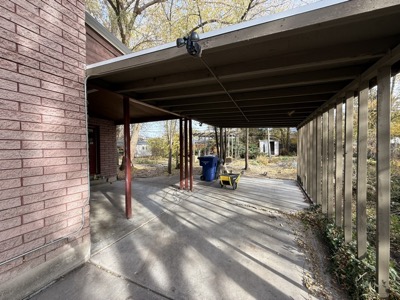

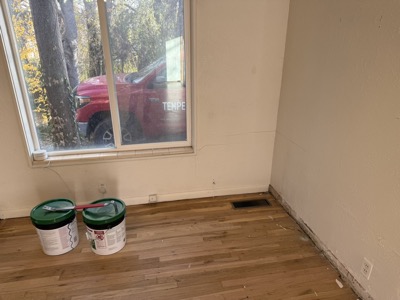

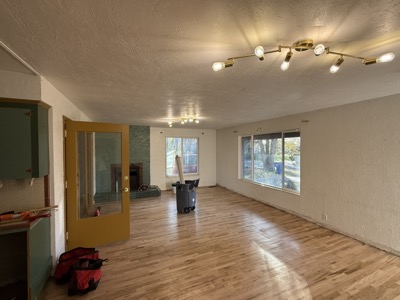

- Nov 12-13 — Closed on house, got keys

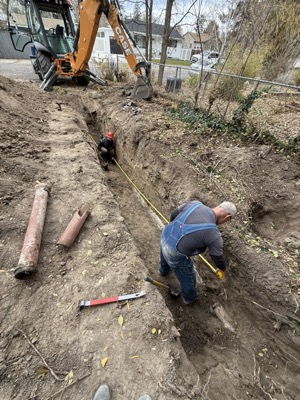

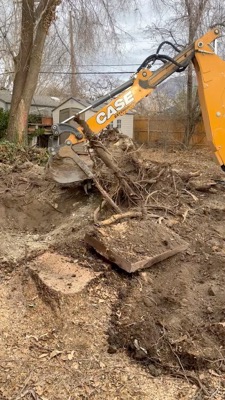

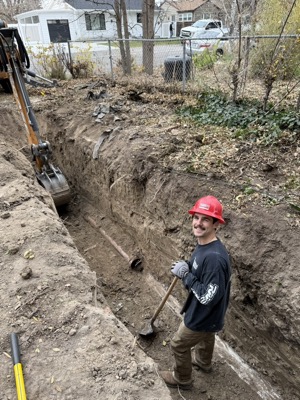

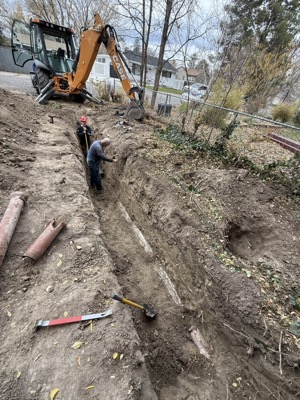

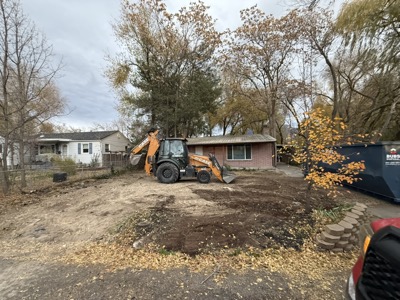

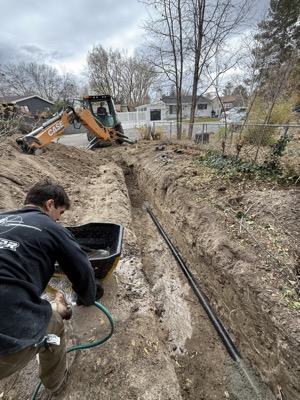

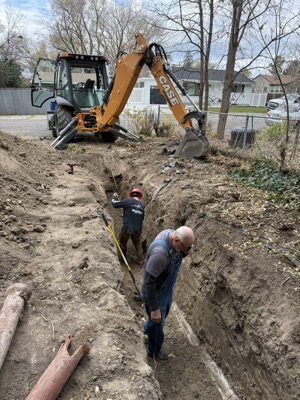

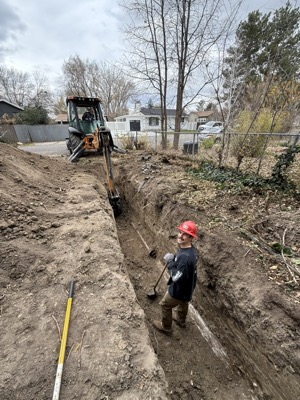

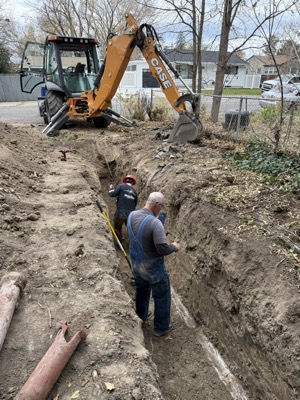

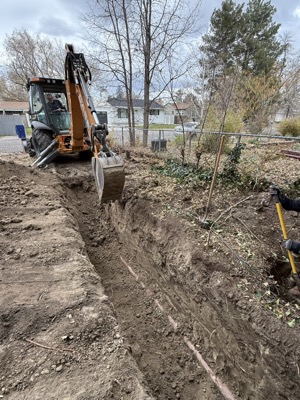

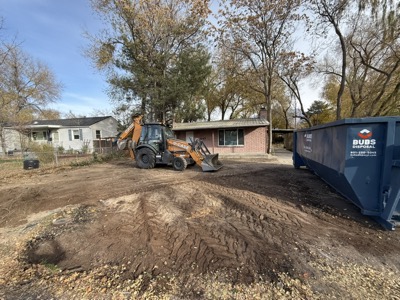

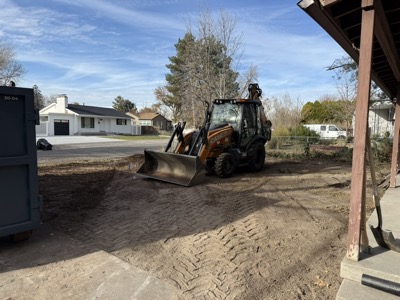

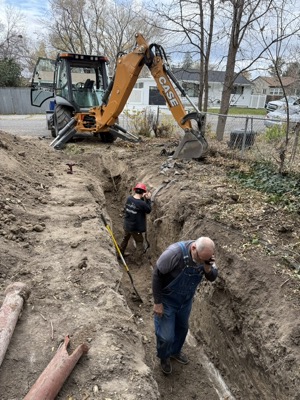

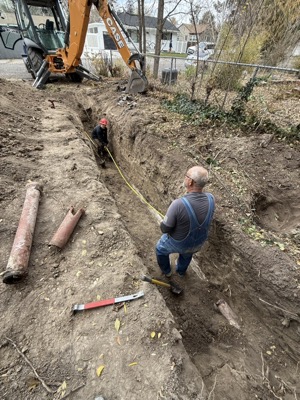

- Nov 14 — Sewer line replacement. Borrowed backhoe from Tempest, done in 4 hours with Curtis and Hayden

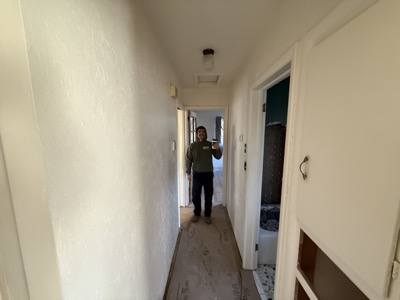

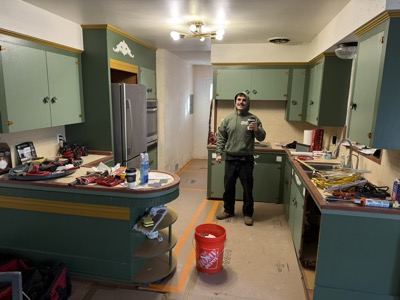

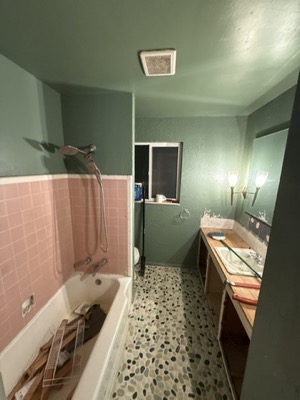

- Nov 22 — Bathroom demo started, Ramboard down
- Nov 26 — Bathroom design mockup finalized

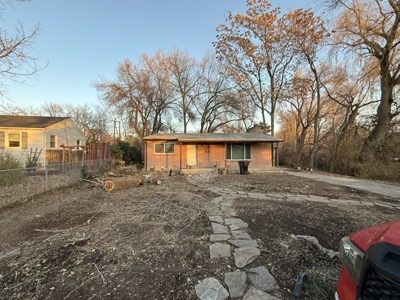

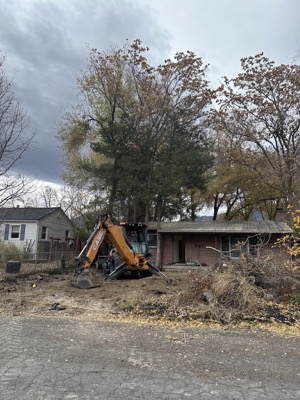

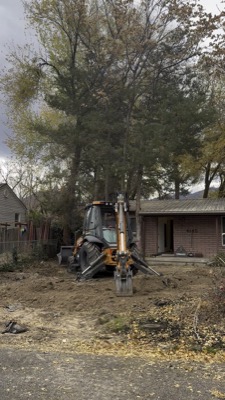

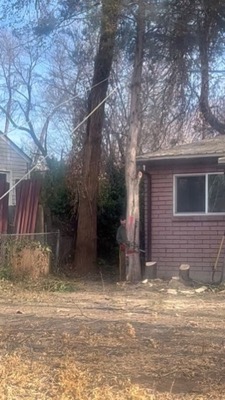

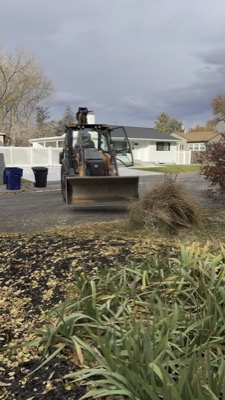

- Nov 29 — Front yard tree removal (chainsaw work)

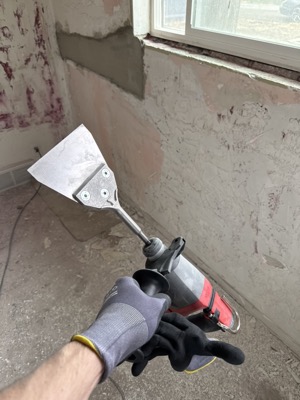

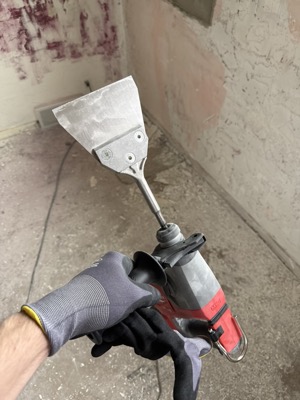

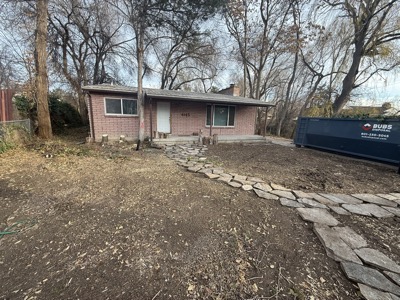

- Dec 6 — Found faster wall scraping tool. Built stone path in front
- Dec 8 — Ordered bathtub and toilet

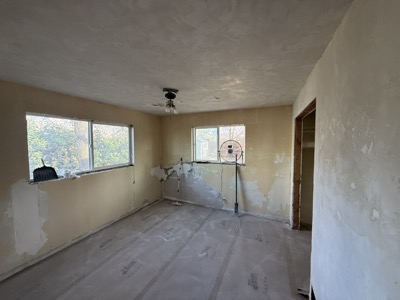

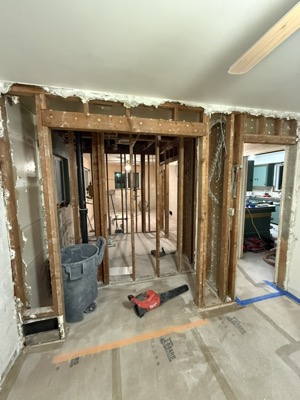

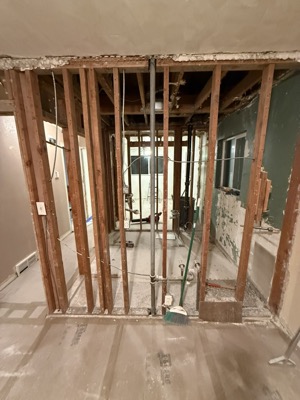

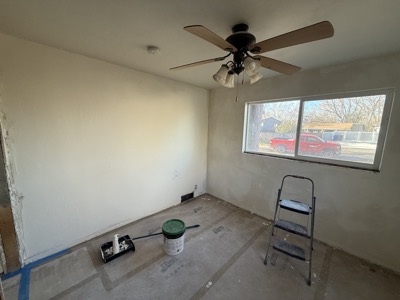

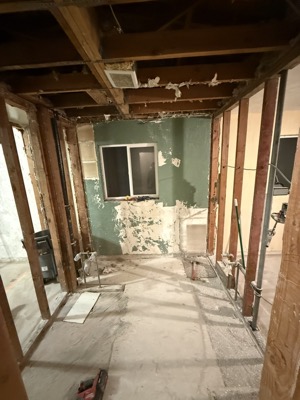

- Dec 10 — Wall demo in bedrooms and bathroom for electrical

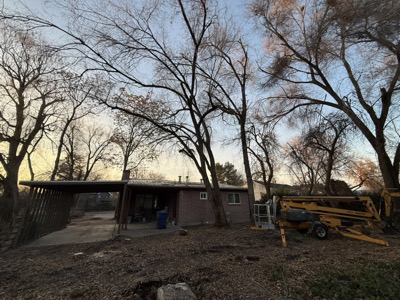

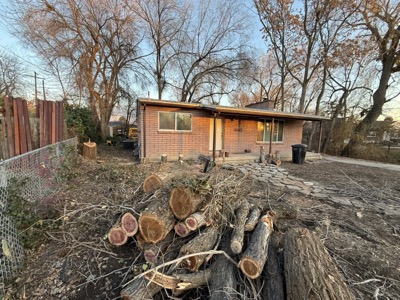

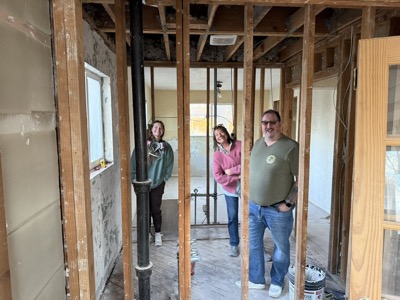

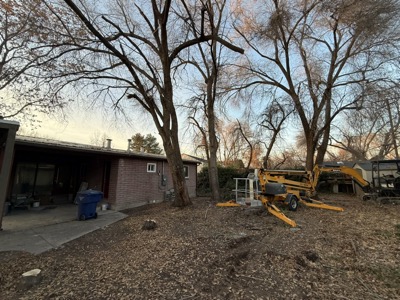

- Dec 15 — Professional tree removal (Timber Ridge). Removed all overhang

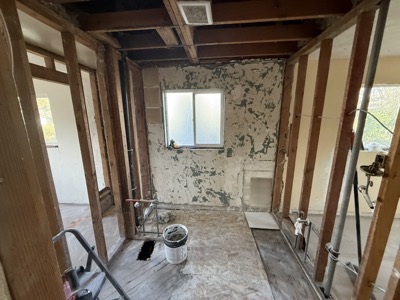

- Dec 17 — Third Life Health helped finish walls. Patched earthquake cracks with mortar/mesh

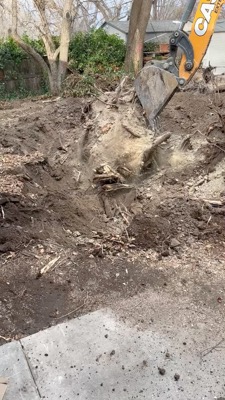

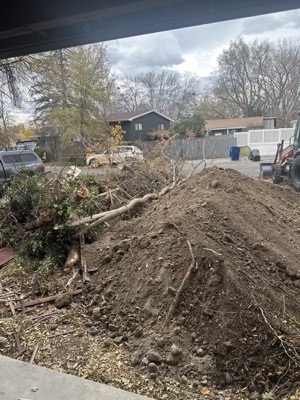

- Dec 22 — Stump removal with backhoe. Saved $1k vs grinding quote

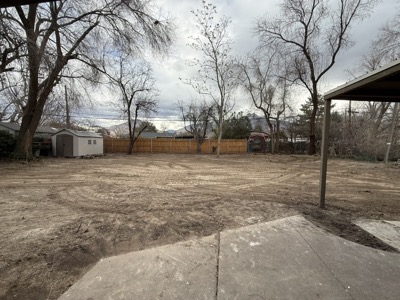

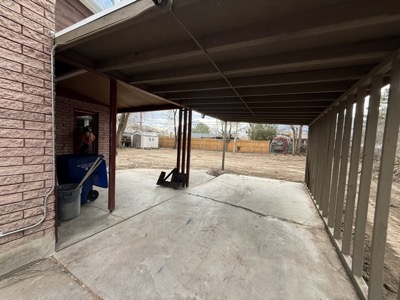

- Dec 24 — Backyard leveled. First time property felt like a good investment

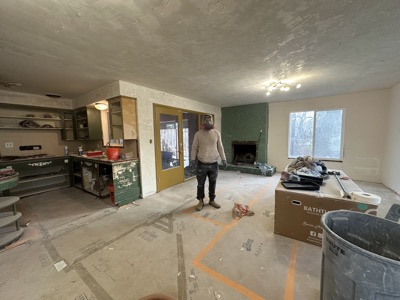

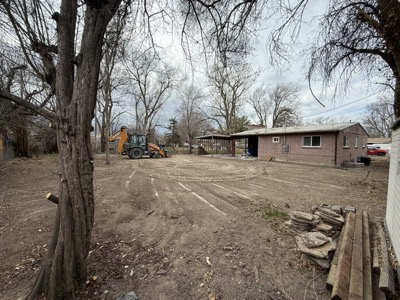

- Dec 26 — Plumbing began. New PEX lines. Removed ancient crawlspace system

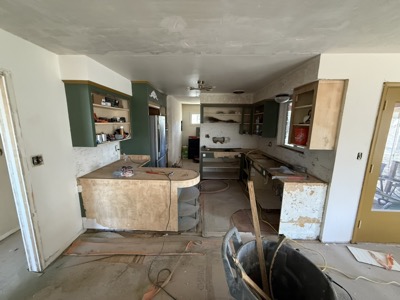

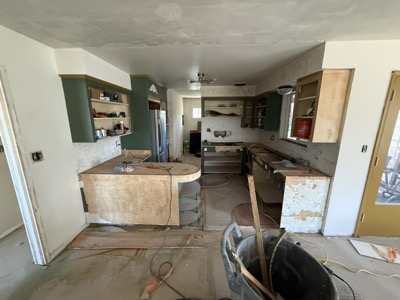

- Dec 29 — Stripped kitchen countertops and backsplash

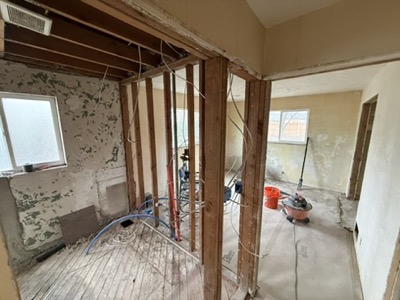

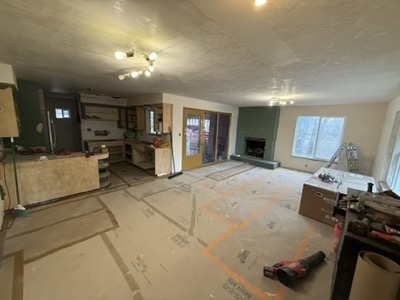

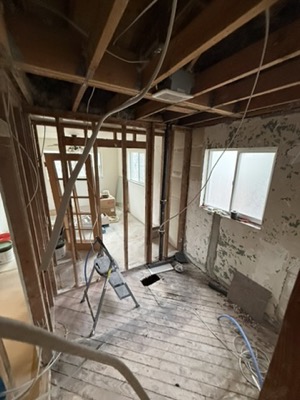

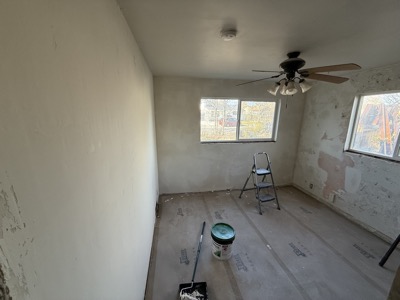

- Jan 2 — Current state. New Ramboard. Kitchen decisions in progress
The Gameplan: 64 Days to Move-In
Working backwards from March 8th. This is the critical path.
Phase 1: Plumbing & Rough-In (Jan 4-19)
2 weeks. Nothing else can happen until plumbing is done.
- Replace all drain lines (kitchen, bathroom, toilet → main sewer)
- Move toilet drain to new location
- Replace cast iron with HDPE
- Move bathroom ductwork to floor near door
- Finish electrical rough-in for bathroom and living room
Phase 2: Subfloor & Walls (Jan 20 - Feb 2)
2 weeks. Get everything closed up.
- Install new plywood subfloor in bathroom
- Put up go-board in wet areas, sheetrock elsewhere
- New drywall in office closet and master bedroom
- Joint compound on all walls (allow dry time)
- Finish windowsill mortar repair
Phase 3: Tile & Fixtures (Feb 3-16)
2 weeks. Bathroom becomes functional.
- Tile bathroom floor and walls
- Install floor heater if doing it
- Frame and install tub
- Install toilet
- Order vanity (if not already)
- Install bathroom electrical (cans, switches)
Phase 4: Kitchen Decisions & Work (Feb 17-28)
~10 days. Make the calls, execute.
- Final decision on cabinets (IKEA one side? both? keep existing?)
- Final decision on countertop (concrete, butcher block, or temporary)
- Finish sanding cabinet doors
- Install whatever cabinet solution you choose
- Cap/reroute kitchen vent
Phase 5: Finishing & Move-In Prep (Mar 1-7)
1 week. The home stretch.
- Install vanity
- Sand and oil windowsill boards
- Install baseboards
- Install door trim, reattach doors
- Install living room cans
- Final cleanup
- Move in March 8th
What Can Wait
These don't block move-in:
- New front door
- Exterior paint
- Roof coating
- Landscaping / sod
- Laundry room upgrades
Kitchen Strategy: The Honest Take
Here's the reality: you're 64 days from move-in, money is tight, and the kitchen is the biggest unknown. Here's how I'd think about it.
Option A: The "Good Enough for Now" Path
Cost: ~$500-1,000. Time: 1 weekend.
- Keep existing lower cabinets (they work, just ugly)
- Finish stripping and sanding the doors you've already started
- Paint or stain them a single color (matte black, white, or natural wood)
- Butcher block countertop from IKEA or Home Depot (~$200-400)
- Leave uppers as-is or remove the weird framing and add open shelving
- Simple tile or peel-and-stick backsplash
This gets you moved in. You can do a full remodel in 1-2 years when you have budget and aren't racing a deadline.
Option B: The "One Side Now" Path
Cost: ~$3-5k. Time: 2-3 weekends.
- IKEA cabinets on one side only (uppers and lowers)
- Keep opposite side as-is for now, paint to match
- Butcher block counter on the new side
- Plan to match the other side next year
Looks a bit mismatched but functional. Some people can live with asymmetry, some can't.
Option C: The "Full Send" Path
Cost: ~$10k. Time: 2-3 weeks.
- Full IKEA kitchen (Emma's design)
- Ceiling-height cabinets
- Concrete or butcher block counters
- Relocate stove if it makes sense
Best result, but risky with your timeline. IKEA delivery can take 2-4 weeks. Assembly takes longer than expected. If anything goes wrong, you miss March 8.
My Recommendation
Go with Option A.
- It's the only path that doesn't risk your move-in date
- Butcher block is actually a great look for a 1956 mid-century home
- Painted or stained existing cabinets can look surprisingly good
- Open shelving above is trendy and easier than new uppers
- You'll have a functional kitchen on day one
- Full remodel becomes a 2027 project when you have time and money
On Countertops
- Butcher block — Warm, fits mid-century, easy to install, can cut yourself. ~$200-400. Needs oiling occasionally.
- Concrete — Cool look but DIY is tricky. Cracks, stains, heavy. Not recommended under time pressure.
- Laminate — Cheap and fast. Not glamorous but functional. Can upgrade later.
Butcher block is the move. It matches the era of the house and you can do it in a day.
On the Stove Relocation
Don't do it now. Moving gas lines or adding electrical for a new range location adds complexity, cost, and time. Use what you have. Revisit when you do the full remodel.
Remaining Tasks
- Replace hot/cold water lines with PEX
- Replace drain lines (kitchen → sewer)
- Replace drain lines (bathroom → sewer)
- Replace drain lines (toilet → sewer)
- Move toilet drain to new location
- Replace cast iron with HDPE
- Finish running electrical to living room
- Install 4-6 overhead cans in living room
- Patch old electrical holes
- Bathroom: 4 cans (1 shower, 2 sides, 1 vanity)
- Consider floor heater (Emmit's gift)
- Demo bathroom
- Order bathtub and toilet
- Move ductwork to floor near door
- Install new plywood subfloor
- Put up go-board / sheetrock
- Tile floor and walls
- Frame and install tub
- Install toilet
- Order and install vanity
- Strip plaster from walls
- Patch earthquake cracks with mortar/mesh
- Finish last windowsill mortar repair
- Sand white oak windowsill boards
- Apply matte oil treatment to wood
- Joint compound on remaining walls
- New drywall in office closet
- New drywall in master bedroom
- Strip countertops and backsplash
- Remove paint from cabinet doors
- Finish sanding cabinet doors
- Decision: Remove top framing for new cabinets?
- Decision: IKEA cabinets (one side or both)?
- Decision: Countertop (concrete or butcher block)?
- Decision: Relocate stove?
- Install new baseboards
- Install door trim
- Reattach doors
- New front door (maybe)
- Final cleanup
Lessons Learned
- Demo takes forever — Stripping plaster, removing baseboards, scraping. It's been two months of this.
- Concrete primer matters — Didn't prime one windowsill. Mortar shifted and cracked. Had to redo it.
- Joint compound thickness — Too thick and it crunches as it dries. Still figuring out the right approach.
- Bubs Disposal — Mid-range pricing but same-day delivery. Text in morning, dumpster that afternoon.
Future Projects
- Exterior paint — Wood siding needs attention
- Roof coating — Aluminum paint, darker gray
- Landscaping — Sod front and back, need to plan deck first
- Laundry room — Stacked washer/dryer, folding table, mudroom bench
- Living room expansion — Long-term goal
- Additional bathroom — Maybe convert laundry or add with master expansion
Photos
88 photos documenting the first 52 days. Click to enlarge.
×
‹
›
On Style
We've realized we might prefer a modern aesthetic, but this is a 1956 house. We're probably going to lean into mid-century modern when we decorate. It'll be a chance to get things that feel like ours rather than just combining what we each brought.
— Mason (with notes from Emma)
